July 23, 2025
-

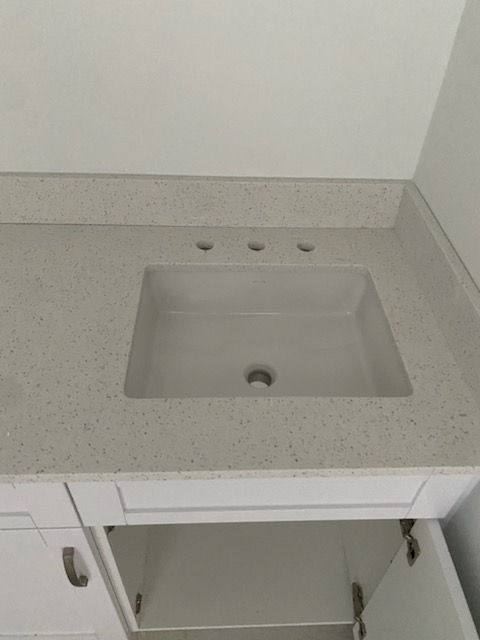

Countertops going in on 2nd floor, sinks being installed, faucets to come soon
-
Roof final inspection done
-
Electrical revision passed inspection
-
Beach renourishment almost done
-
Concrete repairs are ongoing
-
Received shoring plan for back
-
Reminder has been sent to the city on LDO permit for review (it was said, not quick to review documents – hence our delay)
-
The pool permit was received. It seems unusual to get this prior to LDO permit. However, we'll cautiously move ahead.
-
The pool contractor will be notified to start. They will then provide their timeline to completion
-
Step one will be drilling the helical pilings
-
Office, lobby & kitchen electrical inspection today and passed
-
Insulation of first floor in process, followed by inspection
-
Sheetrock in 1 to 2 weeks on floor one (once inspection is complete)
-
RL James needs about one more week to complete concrete on items recently uncovered sections (except north stairwell)
-
Once shoring is in place, the column & balcony repair will take about 2 weeks to complete
-
Floor 2 walkway repair is now underway
-
Stucco companies called to quote stucco repairs now that they can see the scope of work
-
Shoring will need to be in place to fully determine north stairwell situation & scope
-
Awaiting final drawings for FDC
-
Elevator– they checked power, awaiting response from them on a specific date to return
-
Xfinity running lines to the building this week
-
Beach renourishment is at KBC
